Long-Lead Electrical Equipment: Build a Factory Release Schedule

Long-lead electrical equipment planning for a Vietnam factory: order, shipment, installation and energization milestones

Long-lead electrical equipment should be planned against the date a factory needs an authorized, usable electrical system, not simply the date a supplier expects to ship. For an international owner developing a Vietnam factory, the important question is whether equipment, civil works, protection interfaces and connection arrangements converge in time. Buying earlier helps only when the purchase releases the right configuration and the other paths remain credible.

This owner guide explains how to define release milestones, compare conditional quotations and test a procurement programme with parallel dependencies. It provides an original worked example and practical review tables. All example durations are hypothetical elapsed weeks, not current supplier lead times, Vietnamese approval periods or QuangAnhcons project results. Source scopes were checked on 16 October 2026.

1. Specify the endpoint before comparing lead times

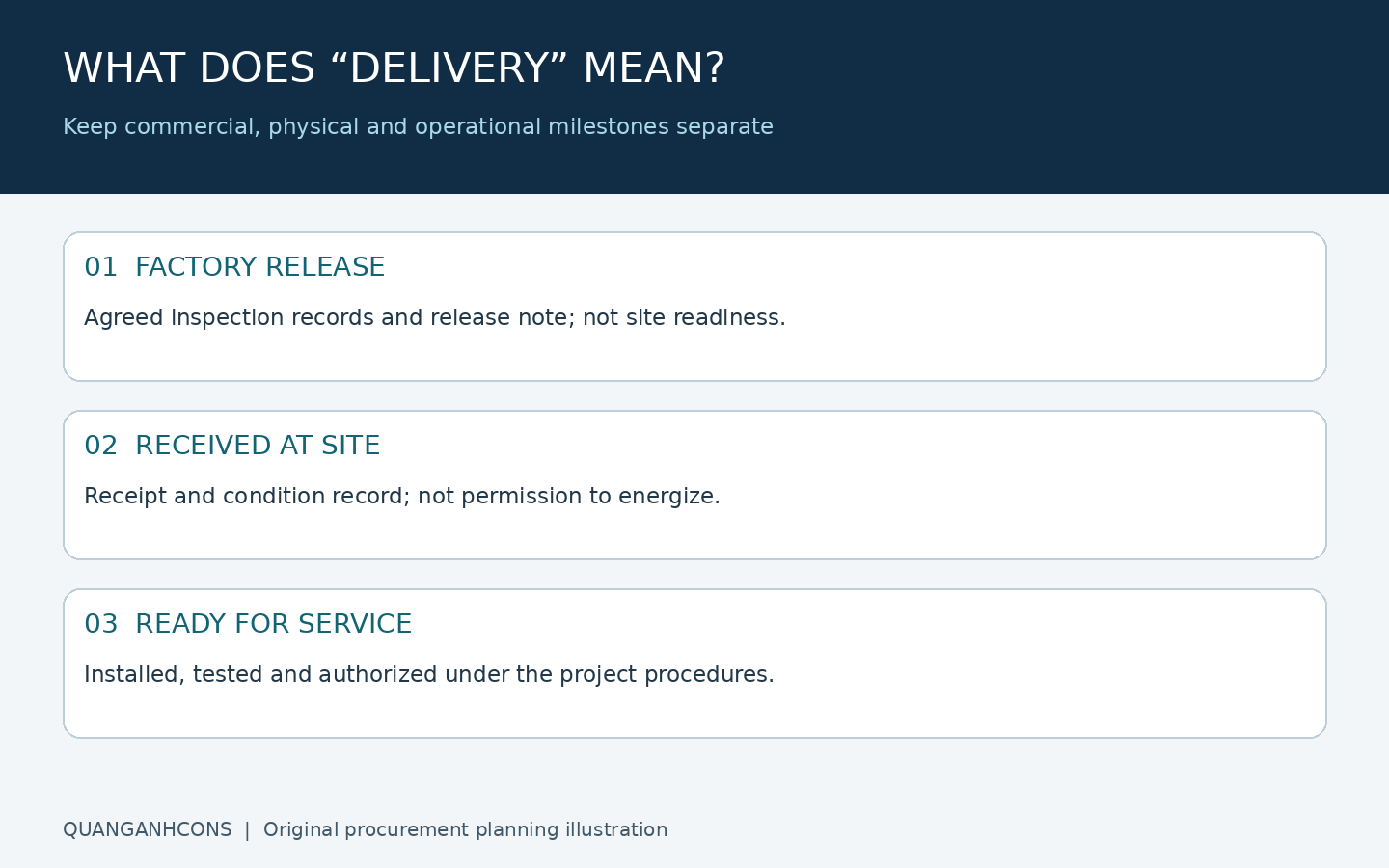

A quotation saying “delivery in fourteen weeks” leaves several questions unanswered. Fourteen weeks from which event? Does the endpoint mean ready for inspection, handed to a carrier, received at the factory, installed or ready for authorized energization? A short duration can be commercially accurate but irrelevant to the owner’s operating date if its start conditions and endpoint differ from the other offers.

Require each bidder to name the configuration, starting event, finish event, assumptions and evidence supporting its forecast. Distinguish an indicative estimate from an accepted contractual commitment. A dated production-slot reservation should identify when it expires and what must happen to convert it into an order or manufacturing release. Neither a reservation nor an advance payment proves that technical interfaces have been resolved.

Milestones that should remain separate in the procurement register
Milestone Evidence to request Still unresolved
Technical baseline accepted Agreed drawing revisions and a disposition of departures Permission to manufacture if commercial or release conditions remain open
Released for manufacture Written authorization identifying the permitted scope and outstanding holds Manufacturing completion, site readiness and connection authorization
Factory acceptance closed Applicable test records and an agreed disposition of outstanding items Transport damage, installation interfaces and site tests
Received and accepted into custody Condition report, packing reconciliation and preservation handover Electrical suitability or permission to energize
Ready for the intended service Project-specific installation, testing and authorization records Other production-process prerequisites outside the electrical package

The GAO Schedule Assessment Guide, GAO-16-89G, published on 22 December 2015, provides a general basis for connecting activities and examining schedule changes. Its scheduling guidance is used here as a project-control method, not as Vietnamese law or a mandatory electrical design standard. The example below is our own simplified application.

2. Freeze the interfaces that determine manufacture

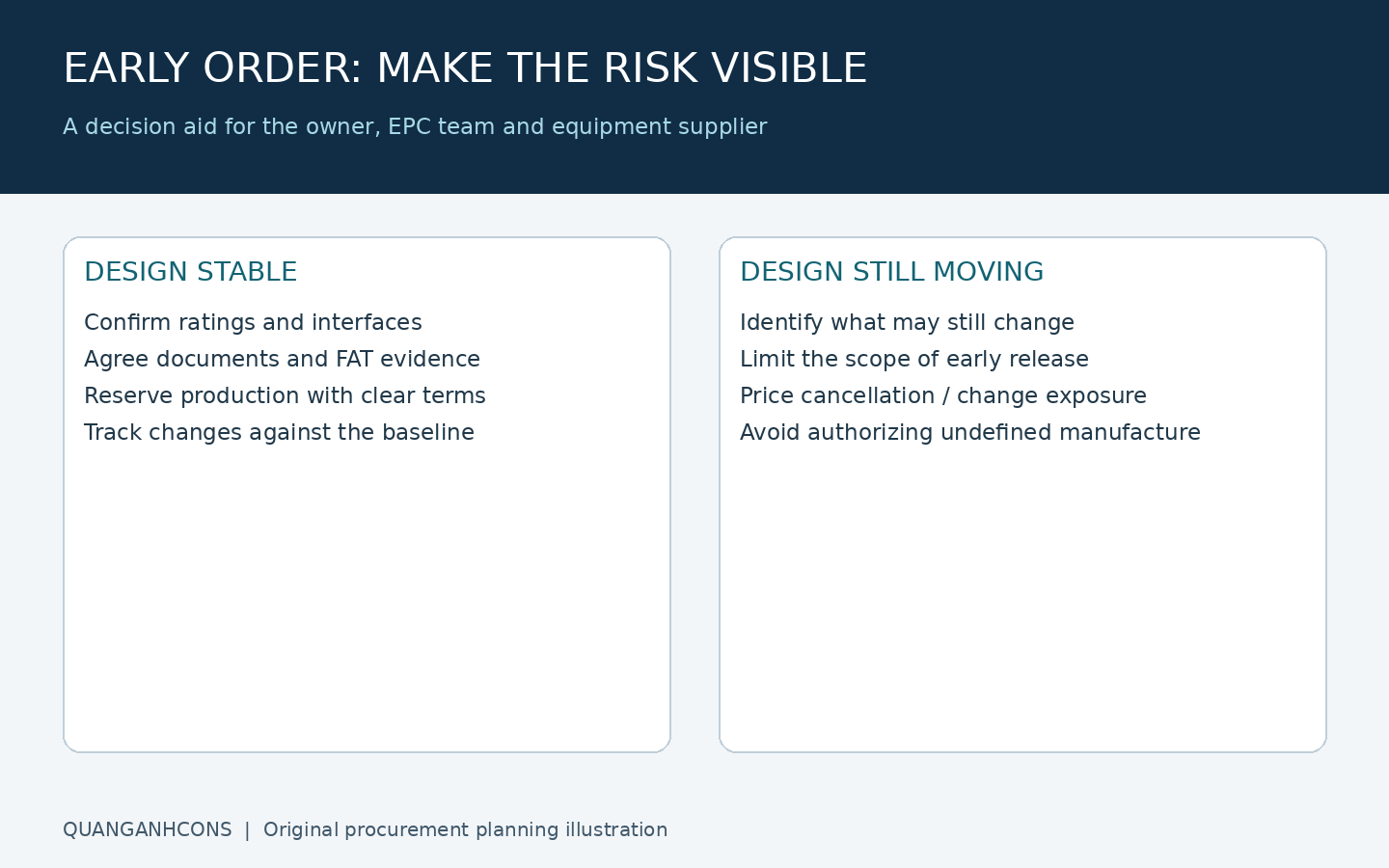

An early purchase is useful when the team can define what may safely proceed. Separate a full manufacturing release from a limited release for stable work. If cable-entry positions, enclosure dimensions or protection interfaces are unresolved, identify the affected fabrication explicitly. Do not issue an unrestricted release and describe the unresolved details only in meeting minutes.

For a factory MV/LV package, assemble a revision-controlled baseline covering the agreed single-line diagram, duty assumptions, equipment arrangement, environmental conditions, cable and bus interfaces, control supplies, interlocks, metering boundaries, access and maintainability. Record who owns each input and who may accept a departure. The equipment manufacturer must identify which missing inputs affect its manufacturing sequence; the procurement team should not infer that a standard enclosure or familiar brand makes the interfaces interchangeable.

Confirm the applicable product standard and edition in the actual specification. The current public catalogue describes IEC 62271-200:2021+AMD1:2024, consolidated edition 3.1, as addressing AC metal-enclosed switchgear above 1 kV through 52 kV. IEC 61439-1:2020, edition 3.0, contains general rules for low-voltage assemblies and is applied with the relevant product part; its catalogue copy incorporates the 2021 and 2023 corrigenda. These scopes do not prove that a proposed assembly is compliant or that its factory tests satisfy the project contract.

No particular transformer, switchgear or protection model has been specified here, so there is no model-specific installation limit, test value or manufacturer delivery commitment to quote. Before award, obtain the exact manufacturer’s current drawings, installation instructions, handling requirements and verification evidence for the offered configuration. Ask the responsible designer to establish applicable Vietnamese legal requirements and dated TCVN/QCVN references for the actual installation. A general procurement programme cannot determine that applicability or invent an approval duration.

Use the factory electrical interface register to organize responsibility boundaries. This schedule guide addresses the timing and release consequences of those inputs, rather than creating a second set of technical ownership rules.

3. Model the paths that must converge

A simple sequential sum is useful for an initial screen, but it can miss a late civil room, a control interface or an authorization step. Represent the main dependencies explicitly. Equipment arrival and room readiness may run in parallel; installation begins only after both have met their relevant release conditions. A planned energization date is not an excuse to assume that a missing prerequisite will be waived.

Hypothetical planning example: time zero is the start of the defined release process. Durations are elapsed weeks on one continuous calendar, with finish-to-start relationships and no resource conflicts, holidays, customs disruption or rework. Tasks finish at the numbered week boundary. The authorization activity is an invented planning placeholder for an already defined project process, not a promise that any authority will respond in one week.

Original dependency model, with all durations illustrative
Activity Duration, weeks Predecessor Earliest start–finish, week
A: Final technical and manufacturing release 2 Start 0–2
B: Manufacture the released equipment 14 A 2–16
C: FAT and agreed closeout 1 B 16–17
D: Transport and receipt 3 C 17–20
E: Civil interface release 1 Start 0–1
F: Room, access and foundation readiness 12 E 1–13
G: Installation and site testing 3 D and F 20–23
H: Protection and control interface records 4 A 2–6
J: Final authorization and service-release process 1 G and H 23–24

The equipment path reaches the site at 2 + 14 + 1 + 3 = 20 weeks. The civil path reaches readiness at 1 + 12 = 13 weeks. Installation therefore starts at max(20, 13) = 20, not at their sum and not at the earlier date. Its finish is 20 + 3 = 23. The final process starts at max(23, 6) = 23 and finishes at week 24. Every term is a time in weeks; there is no conversion between working days and elapsed weeks hidden inside the arithmetic.

Add a separately identified, hypothetical two-week project allowance to set a week-26 target. The physical model is still 24 weeks. The allowance is neither work completed nor permission to shorten testing. If the target represents a fixed calendar date, translate each relative week using the project’s agreed calendar and retain that mapping with the baseline.

Test which delay actually changes the endpoint

If manufacture increases from fourteen to seventeen weeks, arrival moves to week 23. Installation then ends at week 26 and the final process at week 27. Against the unchanged week-26 target, the revised forecast is one week late, after consuming the two-week allowance. Reporting only a three-week manufacturing slip misses the owner’s decision: at least one week must be recovered elsewhere, or the target must change.

Alternatively, keep equipment on baseline and delay civil readiness from week 13 to week 22. Installation cannot begin at week 20; it begins at week 22, ends at week 25 and the final process ends at week 26. That nine-week civil delay uses seven weeks of the original gap between civil readiness and arrival, then consumes the two-week project allowance. It is not nine weeks of final delay. The team should still investigate why the civil forecast changed instead of treating the apparent margin as free time.

Check the result backwards as well. To finish at week 26, the one-week final activity must start by week 25; the three-week installation activity must start by week 22. Thus both arrival and civil readiness must be achieved by week 22 under the stated assumptions. The baseline arrival at week 20 has two weeks of target margin, while civil readiness at week 13 has nine. Those figures depend on this network; they are not generic float allowances for electrical projects.

Finally, an unresolved four-week control-record task cannot be labelled noncritical indefinitely. If it cannot start until week 23, it finishes at week 27 and moves the final process to weeks 27–28, even if physical installation finished at week 23. Recalculate the converging paths whenever a predecessor, duration, calendar or release condition changes.

4. Compare bids on the same release basis

A useful bid comparison separates technical acceptability, contractual scope and forecast timing. Do not average two delivery durations with different starting events. Normalize the comparison by recording the owner actions before each clock can start. If a bidder needs an approved layout, a signed interface schedule and a particular payment milestone, show those dependencies instead of assuming the quotation date starts manufacture.

Owner’s bid clarification register
Question Required answer Decision consequence
What exactly is offered? Configuration, drawings, departures and exclusions Whether comparisons refer to the same deliverable
What starts the duration? Named release conditions and responsible parties Which owner decisions must enter the programme
Which dates are conditional? Expiry, component availability and production-slot assumptions When reconfirmation or reservation is necessary
What closes factory acceptance? Agreed scope, records and outstanding-item disposition Whether dispatch can follow the planned test date
Where does responsibility change? Contract delivery event and precise logistics boundary Who manages transport, receipt and preservation interfaces
What follows arrival? Site support, missing components, testing and documentation Whether early receipt advances usable service

Delivery terminology deserves a separate commercial review. The International Trade Administration overview of Incoterms explains that these rules allocate delivery-related responsibilities but do not settle all sale-contract issues. Do not rely on a trade abbreviation to establish payment terms, ownership transfer, commissioning obligations or delay remedies. Record the selected edition and named place precisely and have the contract team resolve the remaining obligations.

The ICC Academy explanation dated 31 July 2025 also distinguishes contractual delivery from arrival at destination. This matters when a supplier’s delivery milestone precedes the date the factory expects physical receipt. Align the schedule labels with the negotiated contract; this guide does not choose an Incoterms rule or interpret a specific transaction.

5. Use controlled release gates, not optimistic percentages

Before manufacture, the owner should be able to point to the approved configuration, the person authorizing release and the boundary of any limited instruction. Record unresolved matters as specific holds with decision dates. “Ninety percent drawings complete” does not reveal whether the missing ten percent changes the cable compartment or prevents fabrication of the enclosure.

Before FAT, align the inspection and test plan, attendance arrangements, notification periods, document availability and the handling of deviations. Agree which conditions block release and which, if any, may be carried forward under an authorized disposition. Do not convert an unsigned test sheet into an achieved acceptance milestone. For the wider evidence structure, use the electrical inspection and test plan guide.

Before dispatch, review physical readiness and documentary readiness together. The site team should confirm access, unloading arrangements, room or foundation release, storage conditions and preservation responsibility. The logistics team should identify transaction-specific documentation with its responsible advisers. The electrical contractor should verify that the arriving scope matches the planned installation sequence. No photograph or shipping notice substitutes for these separate decisions.

Before energization, use the actual project’s authorized procedure, competent personnel and approved safe system of work. Procurement staff must not bypass isolation, lockout, testing, protection review or operational handover to protect a delivery KPI. For an operating factory, coordinate the change with the brownfield isolation and tie-in plan; equipment availability alone does not create an acceptable outage window.

6. Recover a slipping package without moving risk out of sight

Start recovery with a constraint statement: the blocked activity, the missing input or component, the latest supporting evidence, the revised finish and the decision deadline. “Supplier is expediting” is an action description, not a forecast. Retain the baseline, record the current forecast separately and identify the party empowered to approve the proposed change.

Partial shipment can help only when the delivered portion enables genuinely independent work. Ask what remains outstanding, who installs it, how preservation and responsibility change, and which tests must be repeated or deferred. Compare the revised date of usable service, not the number of crates received. Shipping incomplete equipment can increase site work or damage a previously clear acceptance boundary.

A proposed substitute requires review of the exact technical interfaces and verification evidence, not merely matching brand, voltage or nominal current. Have the designer and responsible manufacturer assess the actual departure, update controlled documents and establish its consequences for installation, operation and testing. No substitution, temporary supply or reduced test scope is pre-approved by this article.

Recovery options should include their prerequisites and remaining uncertainties. Earlier owner decisions, genuinely available production capacity, a different logistics arrangement or a safe resequencing of independent site work may each help in a particular case. None is a universal remedy. If the evidence cannot support the target, present the shortfall and its production consequence to the owner instead of silently changing the definition of completion.

7. Issue a decision-ready RFQ and maintain one control record

Ask bidders for a dated, configuration-specific sequence covering owner inputs, drawing reviews, manufacturing release, manufacture, FAT closeout, contractual delivery, physical receipt and site support. Require assumptions, exclusions, quotation validity, reservation conditions and change consequences. Ask which dates are committed and which remain estimates, and require notice when the supporting assumptions change.

Maintain a package record containing the stable equipment identifier, document revisions, baseline and forecast milestones, evidence date, unresolved interface, responsible decision-maker and next action. Record actual completion only when its agreed evidence exists. Track the decision needed next week as carefully as the shipment due next quarter; the later event often depends on the earlier decision remaining visible.

For a QuangAnhcons scope discussion, provide the intended operating date, site and supply-boundary information, single-line diagram, load schedule, equipment list, current quotations and interface drawings. Identify the owner-supplied packages and any existing-factory outage constraints. Share sensitive drawings and commercial terms through an agreed private channel, not a public comment. The useful first output is a list of unresolved inputs and responsibilities, not an unsupported lead-time promise.

Sources, limits and owner review

The linked GAO guide supports the general scheduling method; the two trade sources clarify delivery terminology; the IEC public catalogues establish only the named publication scopes and editions. The dependency model, calculations, release tables and RFQ questions are original illustrative planning tools. They are not copied manufacturer instructions, a statutory compliance assessment or a representation of a completed QuangAnhcons project. Replace every hypothetical duration with dated project evidence before commitment, and obtain the relevant engineering, contractual and local-authority reviews for the actual scope.
