How much does it cost to construct a 400kVA substation in Vietnam?

In an era where uninterrupted power supply forms the backbone of technological and economic advancements, the expansion of electrical transmission capabilities is paramount. Embarking on the venture to lay down a 22KV transmission line alongside setting up a 400kVA 22/0.4KV substation signifies a proactive approach to cater to the escalating power demands. This project is distinguished by its thorough component selection and the employment of experts to install and integrate the transmission line and substation seamlessly into the grid. Emphasis is placed on conforming to the newest industry protocols and collaborating effectively with energy oversight agencies. Detailed exploration of this project will cover the diverse aspects from component detailing, through the intricacies of project realization, to financial disbursements, offering comprehensive insights into the endeavor.

CONSTRUCTION ESTIMATE OVERVIEW

1. 22KV Transmission Line Componentry:

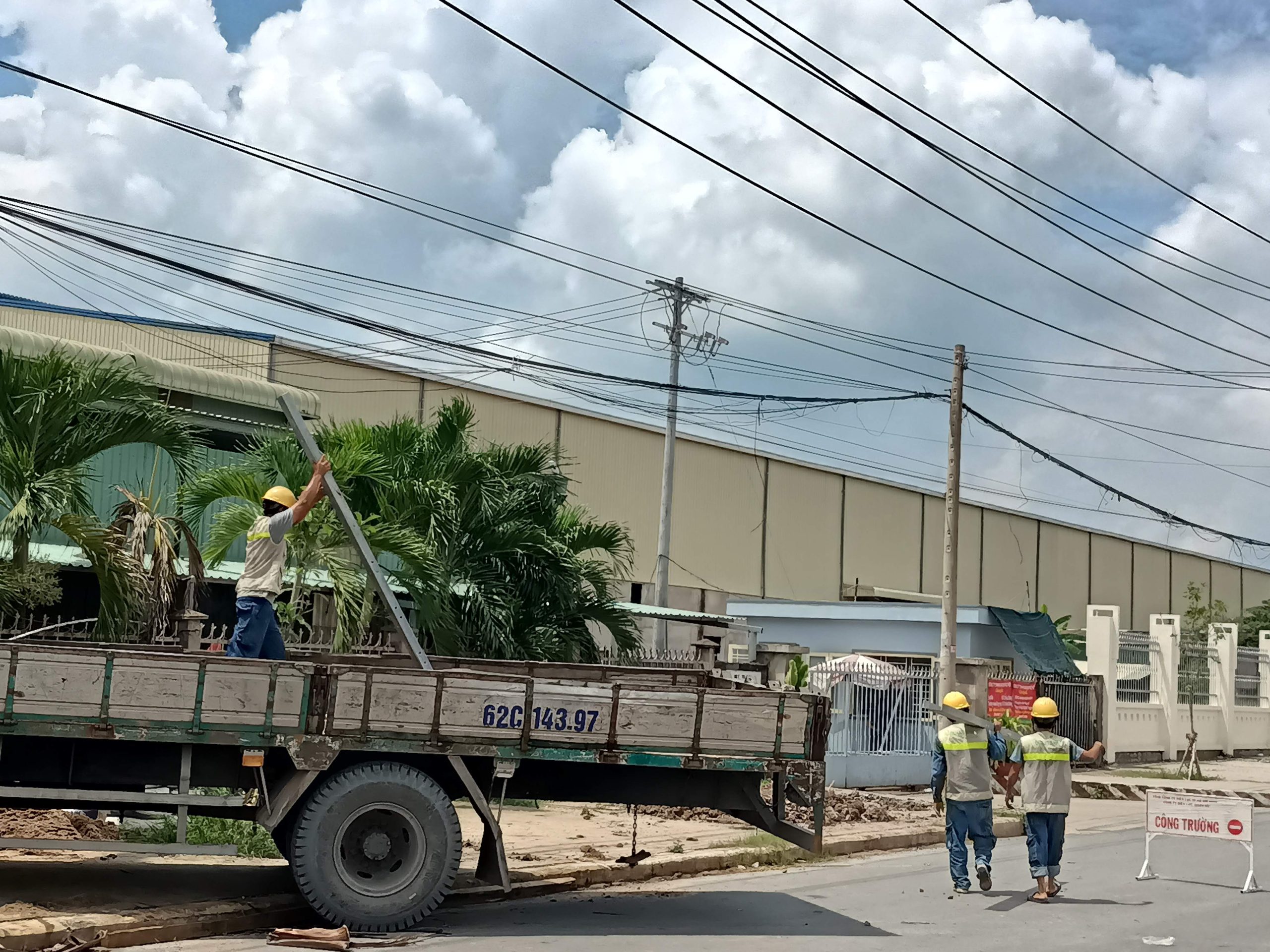

400kva substation

A detailed roster of high-caliber materials and labor is curated for the 22KV transmission line installation, critical for electricity distribution:

– Reinforced Concrete Poles: 14m in height, manufactured via centrifugal spinning for superior endurance and stability.

– Galvanized Iron Braces: Cut to exacting standards, these components ensure a durable edifice for transmission lines.

– Zinc-Coated Bracing Bars: Offering robust support and longevity under environmental stress.

– High-Voltage Standoff Insulators: Providing dependable service in a high-tension environment.

– Advanced Polymer Insulators: Designed for high voltage, ensuring consistent operation of the transmission lines.

– Insulated Phase Conductor Cables: Essential for the effective transmission of electric power.

– Bare Neutral Conductors: Integral for system balance, ensuring operational stability.

– Phase-Conducting Insulated Cables: Serving a vital role within the transmission infrastructure.

– High-Capacity Fuse Cutout Units: Ensuring safety and functional integrity at high operating voltages.

– Essential Lead Wires: Forming the connective pathways in the electrical grid.

– Protective Fuse Cutout Caps: Providing critical safeguarding for electric circuit components.

– Structural Composite Braces: Ensuring the transmission structure’s resilience.

– Precision Electronic Meters: For accurate monitoring of power consumption.

– High-Voltage Multi-Core Cables: For secured power flow within the system.

– Meter Housing Cabinets: Robustly built to protect vital metering equipment.

– System Grounding Solutions: Essential for overall system safety and reliability.

– Foundation Anchoring: To securely affix the transmission line structures.

– Specialized Testing Services: To validate each component against stringent standards.

– Complementary Transmission Accessories: Completing the installation with all necessary ancillaries.

– Skilled Labor Packages: Delivering expert installation and setup services.

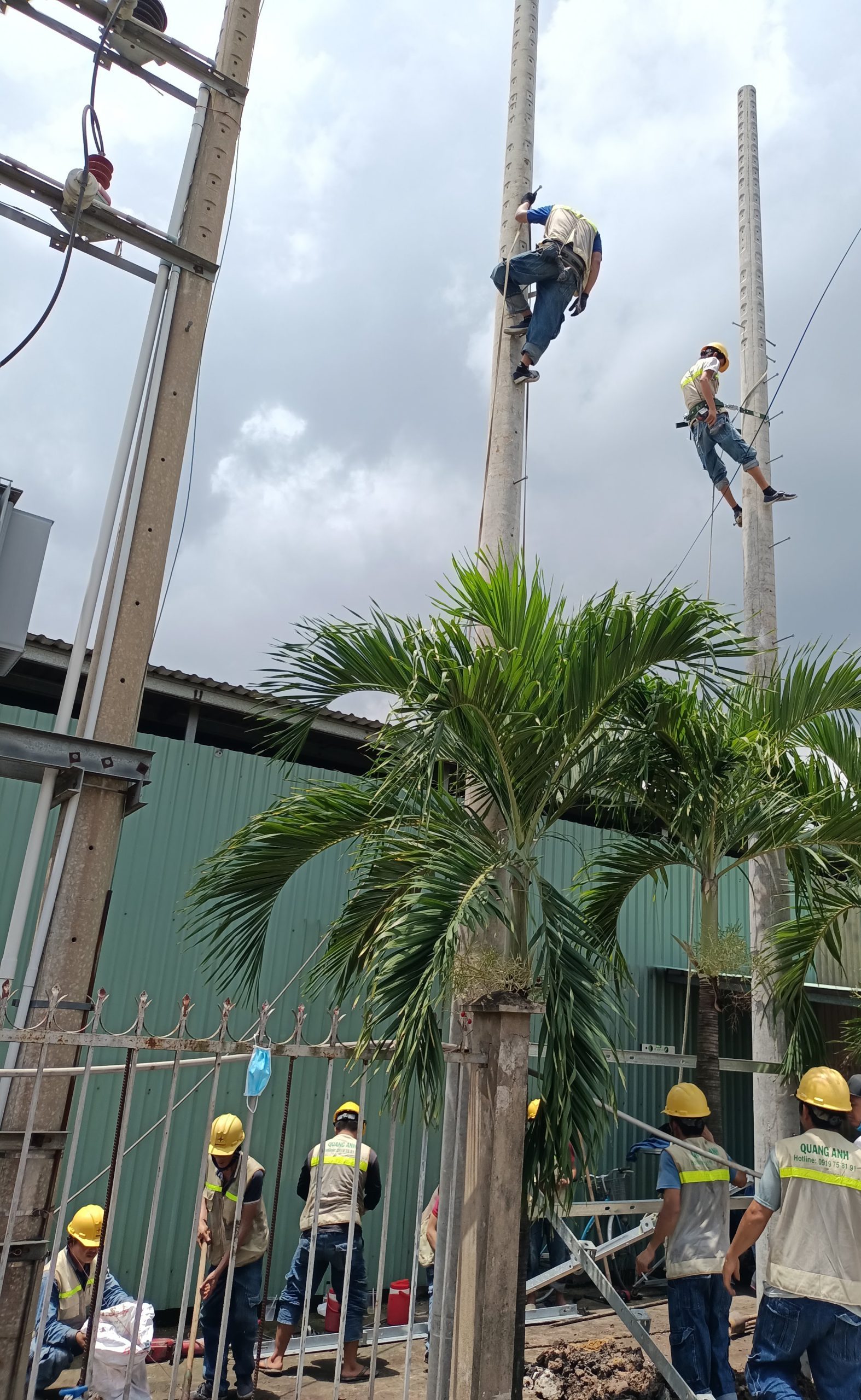

2. 400kVA Substation Assembly – 22/0.4KV:

400kva substation

Constructing an advanced 400kVA substation demands a precise collection of hardware and expert services:

– High-Durability Poles: Dual 14m centrifugally spun concrete pillars form the structural backbone.

– Versatile Iron Braces: Varied dimensions and functionalities to suit all substation structural requirements.

– Polymer High-Voltage Insulators: Equipped with support rods, ensuring steadfast operation.

– High-Performance Electrical Cables: Rated for medium voltage to ensure seamless power distribution.

– State-of-the-Art Transformer Unit: A three-phase, 400kVA engine of the substation.

– Complete Protection Assembly: Including fuse cutouts, lightning arresters, and metering solutions.

– Modern Switchboard Cabinet: Integrated with MCCB and compensation panels for optimal power factor.

– Rigorous Equipment Testing: A step to guarantee the substation’s operational excellence.

– Comprehensive Labor Provision: Ensuring that every phase of assembly is executed flawlessly.

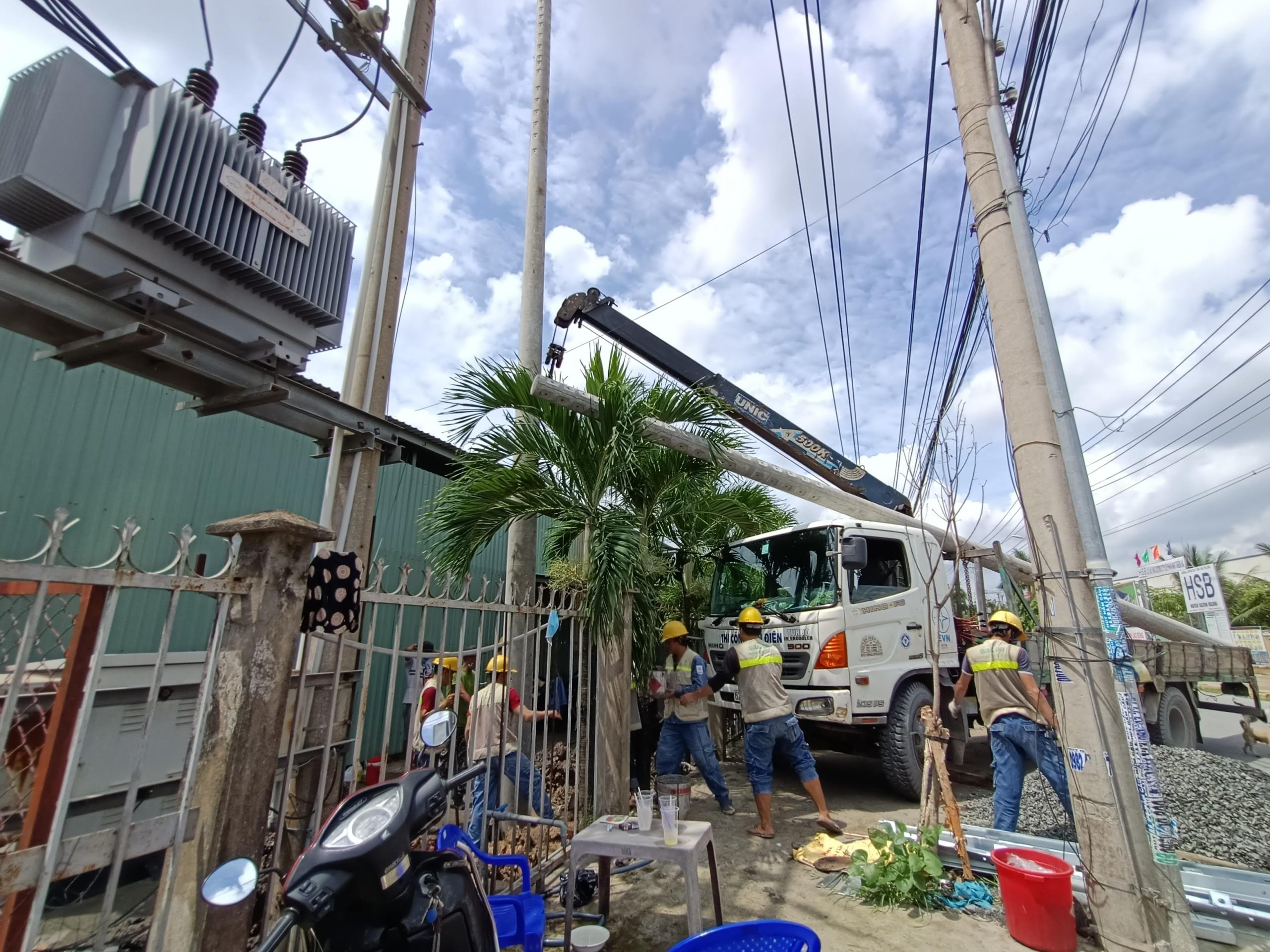

3. Ancillary Expenditures:

400kva substation

Additional costs cover the project’s auxiliary needs, from inception through to finalization:

– Design and Project Valuation Costs

– Supervision and Oversight Expenditures

– Safe Electrical Disconnection Fees

– Testing and Commissioning Outlays

– Transportation and Material Logistics

4. Project Financial Synopsis

In total cost, you can find all of the items mentioned above in our video.

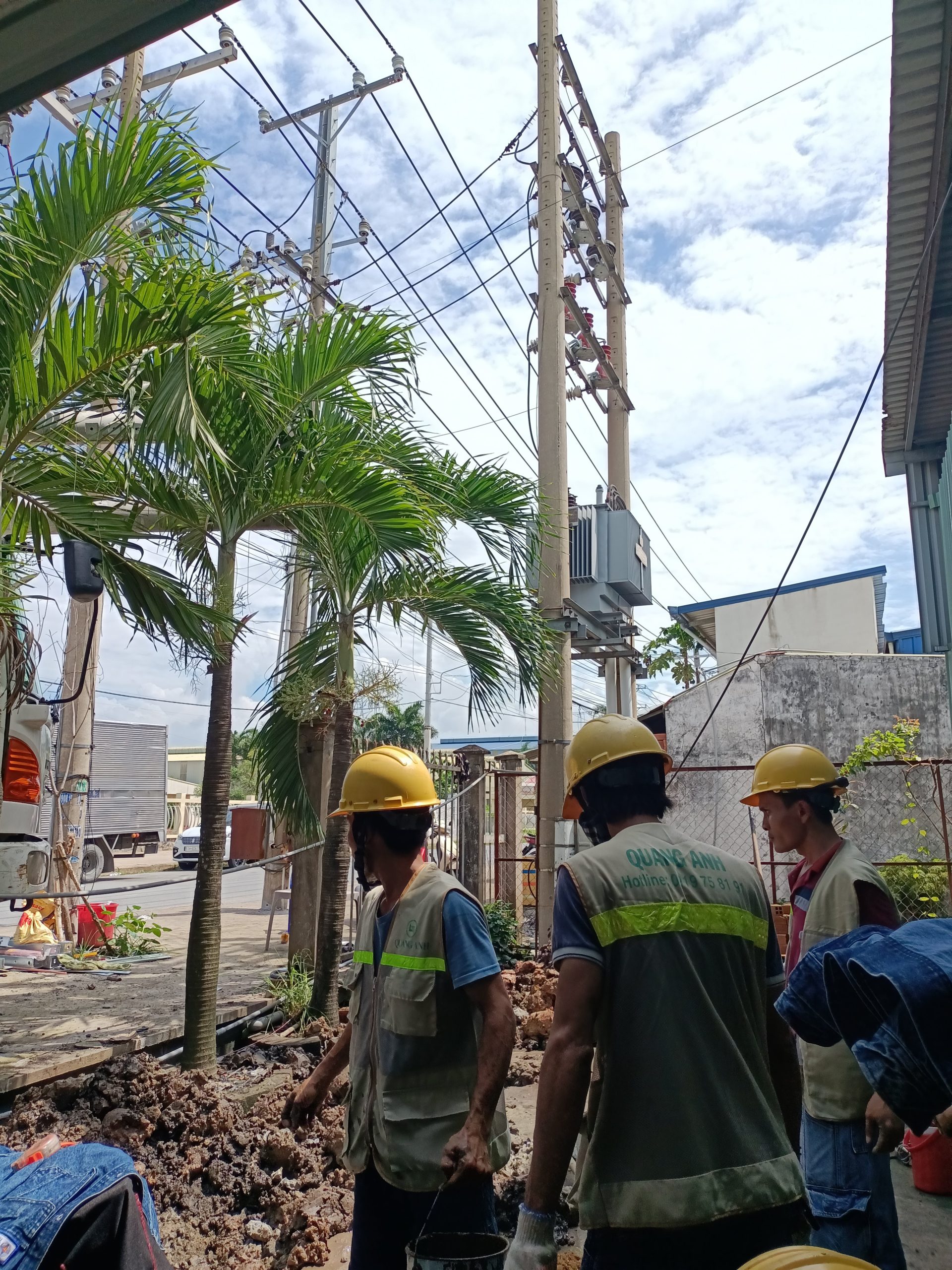

400kva substation

Main Construction Workflow

Our construction blueprint encapsulates meticulous planning and implementation phases, from greenlighting project documentation to the culmination of a fully operational 400kVA transformer station. A standard 45-day timeline is envisioned for the project, ensuring swift and seamless execution.

Financing Structure and Assurances

The financial engagement is structured into three installments, each pegged to project milestones. Webolster our commitment with a comprehensive 12-month warranty and an attentive after-sales service framework.

Engage with Quang Anh CE Co.,LTD

Engage with us for precision-engineered 400kVA – 22/0.4KV transformer station construction, where cutting-edge technology meets unwavering dedication to energy management.

Documented Processes for 400kVA Substation

Commencing the 400kVA substation in Vietnam entails a structured sequence of legal and regulatory steps, ensuring your project aligns perfectly with national standards.

For the successful construction of a 400kVA transformer station within the jurisdiction of Vietnam, it is imperative to be well-versed with the nation’s unique legal framework and regulatory protocols. This outline will guide you through the essential procedural labyrinth, ensuring your project’s compliance from the ground up.

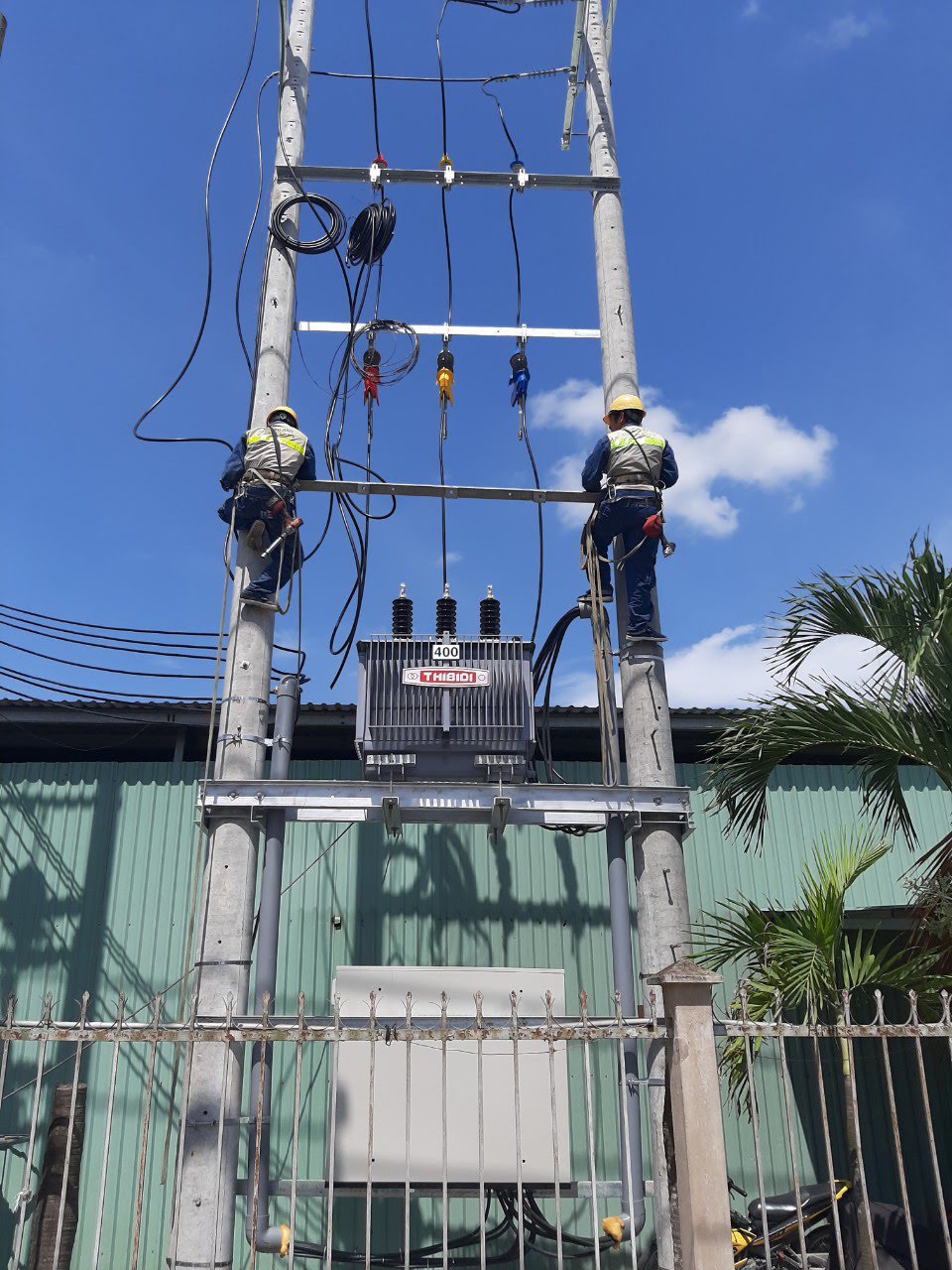

400kva substation

Essential Legal Framework and Procedural Guide:

Foundational Document Collection:

Initiating the project involves compiling a dossier of key legal documents. These include the latest land use rights certificates or relevant lease agreements, valid business permits, identification of the company’s legal representative, and up-to-date environmental protection plans, all verified within the last quarter.

Electricity Purchase Application Initiation:

Kickstarting the construction involves submitting an application for electricity procurement. This essential document is presented to the local Power Company or the Business Department of Vietnam Electricity Group, activating the project’s initial phase.

Electricity Utilization Site Specification:

It is mandatory to delineate the intended site for electricity usage, along with its purpose. This detail requires backing through documents proving ownership or legal use of the property, identification documents of the responsible party, and a business operation certificate or investment permit.

Connection Standardization Submission:

The journey continues with a submission outlining standardized connection plans, replete with comprehensive schematics and technical dossiers, adhering to the Ministry of Industry and Trade’s guidelines.

In-Depth Site Survey & Expert Discussions:

Following the connection blueprint submission, an exhaustive site survey is performed by the Power Company. This process includes expert consultations to settle on the technical specifications and the precise connection locale.

Finalization of Investment Contract & Legalities:

Aligning with the Electric Power Development Plan is a requisite step, encompassing obtaining the relevant building permits and devising an environmental protection strategy.

Onset of Construction & Structural Development:

Physical construction commences with thorough land setup, the acquisition of requisite materials and equipment, and the execution of the construction phase, all under rigorous quality standards.

Operational Commissioning & Substation Activation:

The project reaches fruition with a formal operational commissioning phase, followed by systematic acceptance checks, leading to the energization of the station, overseen by the Power Company’s representatives.

Navigating these procedural milestones is crucial for the seamless integration of the 400kVA transformer station into Vietnam’s power grid, assuring that each step is in lockstep with the regulatory demands and quality benchmarks set forth by the authorities.

400kva substation

Contact for a Tailored Experience

For an in-depth project estimate and personalized advisory, reach out to our team:

Quang Anh CE Co.,LTD

– Contact Number: (+84) 9 1975 8191

– Email Address: project@quanganhcons.com

– Office Location:Unit 02, 08th floor, Pearl Plaza Building, 561A Dien Bien Phu Street, Ward 25, Binh Thanh District, Ho Chi Minh City

– Operational Hours: Monday to Friday, from 8:00 am to 5:00 pm.

Please Note: All provided figures are estimations and may vary based on site conditions and market variables. Our direct communication channels are open for real-time updates and custom solutions.
